Tentative Project Schedule
- Advertise for Construction: Fall, 2023
- Tracy Homelessness Advisory Committee Review of Award
- Recommendation: Winter, 2023
- Construction Contract Award: Winter, 2023/24
- Construction: 300 Business Days in 2024
- National Environmental Protection Act (NEPA): San Joaquin County conducted an Environmental Assessment in 2023 and released a Finding of No Significant Impact on January 18, 2024

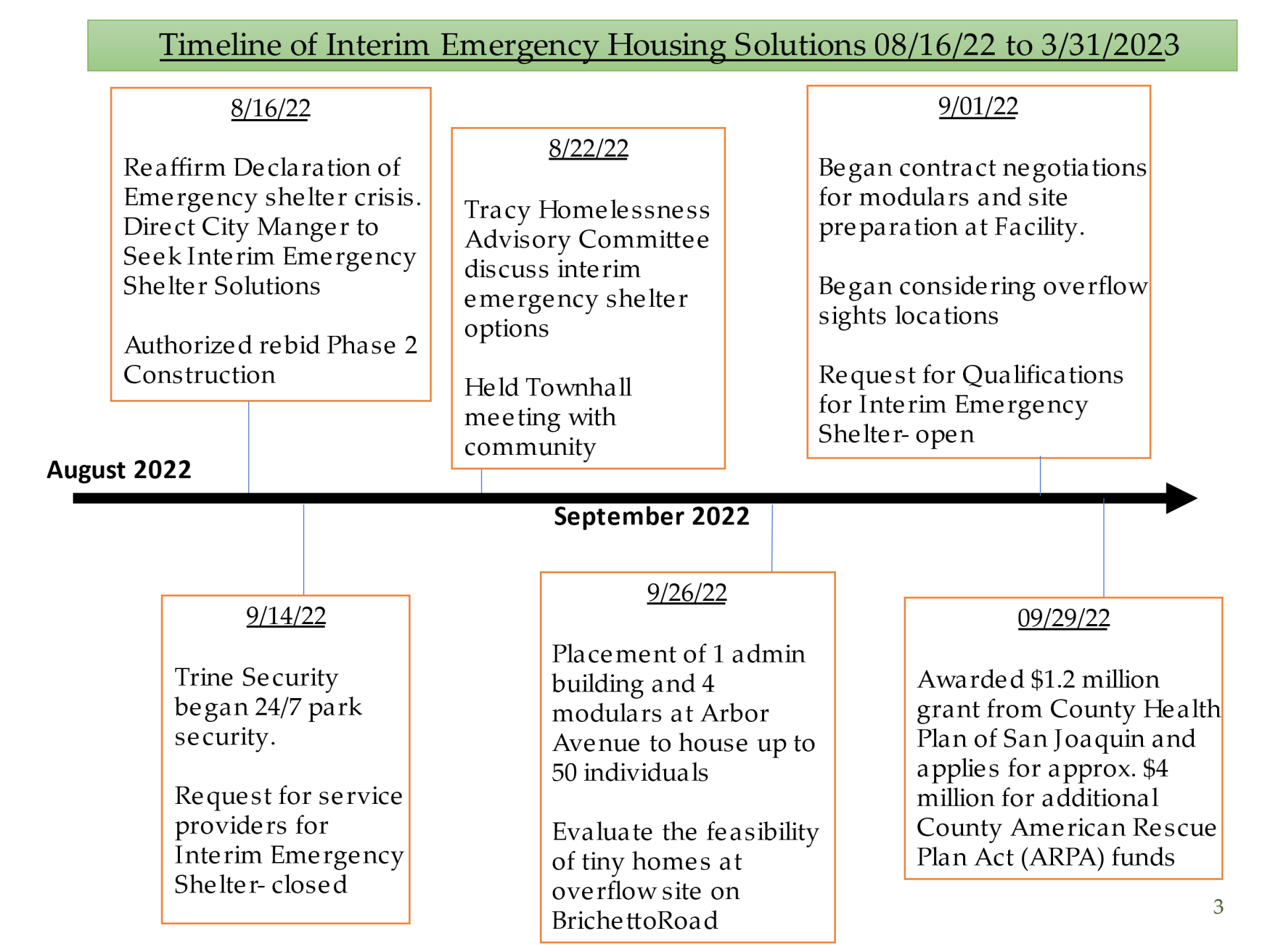

August 16, 2022
City Council reaffirmed the declaration of an emergency shelter crisis and directed the City Manager to seek interim emergency shelter solutions.
Council authorized rebidding Phase 2 construction.
August 22, 2022
The Tracy Homelessness Advisory Committee discussed interim emergency shelter options.
The City held a town hall meeting with the community.
September 1, 2022
The City began contract negotiations for modular units and site preparation at the facility, and began considering overflow site locations.
A Request for Qualifications for interim emergency shelter opened.
September 14, 2022
Trine Security began 24/7 park security.
The Request for Qualifications for interim emergency shelter service providers closed.
September 26, 2022
One administration building and four modular units were placed at the Arbor Avenue site to house up to 50 people.
The City began evaluating the feasibility of tiny homes at an overflow site on Brichetto Road.
September 29, 2022
The City was awarded a $1.2 million grant from the Health Plan of San Joaquin and applied for approximately $4 million in additional County American Rescue Plan Act (ARPA) funds.

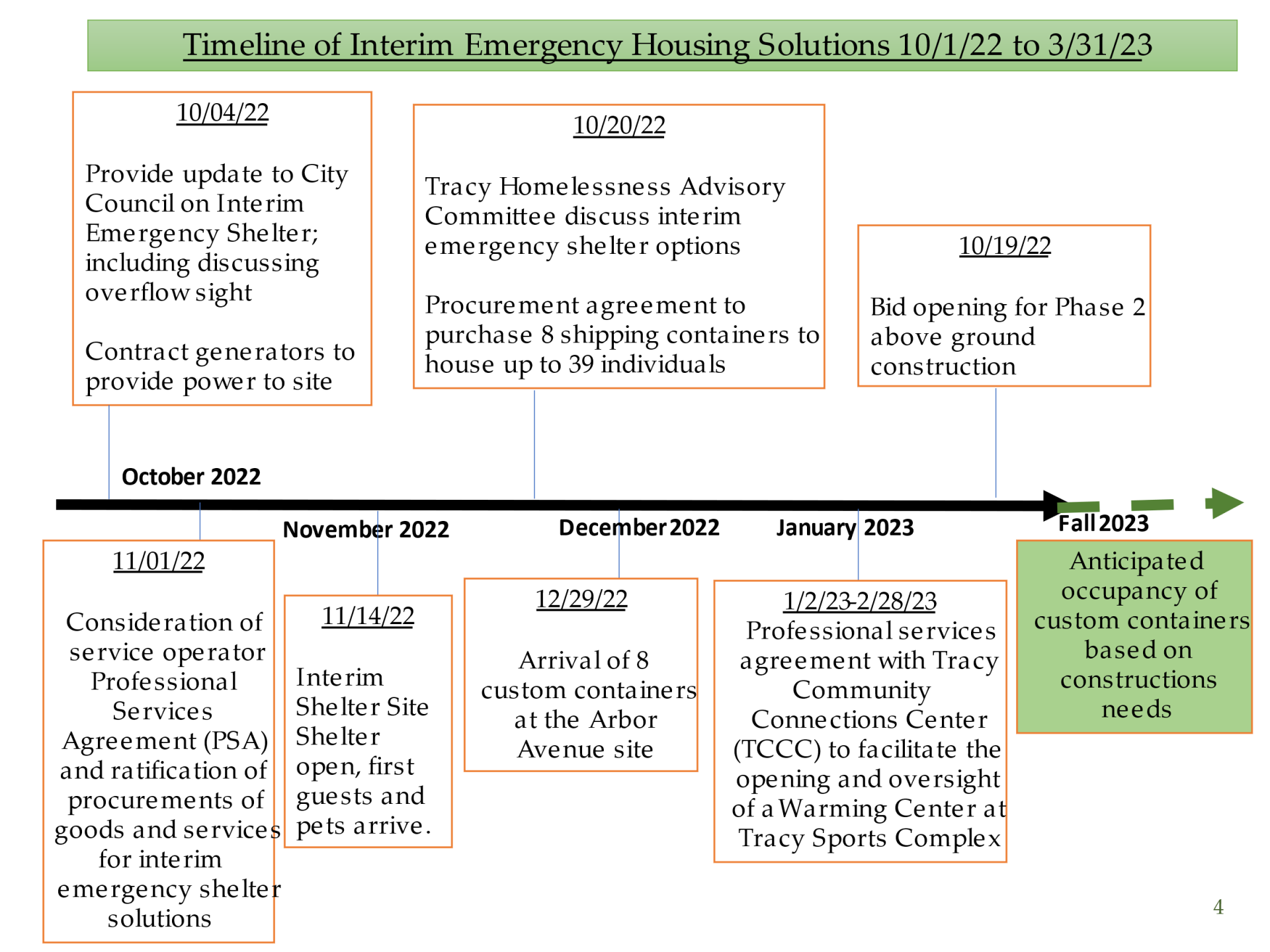

October 4, 2022
Staff provided an update to City Council on the interim emergency shelter, including the overflow site.
The City contracted generators to provide power to the site.
October 19, 2022
Bids opened for Phase 2 above-ground construction.
October 20, 2022
The Tracy Homelessness Advisory Committee discussed interim emergency shelter options.
The City approved a procurement agreement to purchase eight shipping containers to house up to 39 people.
November 1, 2022
City Council considered a professional services agreement with a shelter service operator and ratified procurement of goods and services for interim emergency shelter solutions.
November 14, 2022
The interim shelter site opened, and the first guests and pets arrived.
December 29, 2022
Eight custom containers arrived at the Arbor Avenue site.
January 2 – February 28, 2023
The City entered a professional services agreement with Tracy Community Connections Center (TCCC) to open and oversee a warming center at the Tracy Sports Complex.
Fall 2023
Anticipated occupancy of the custom containers, depending on construction needs.
September 1, 2020
Council direction to move forward with the development of plans for the design and construction of a temporary emergency housing facility.
March 2, 2021
Funding allocated for design and construction
July 13, 2021
June 7, 2022
October 2022

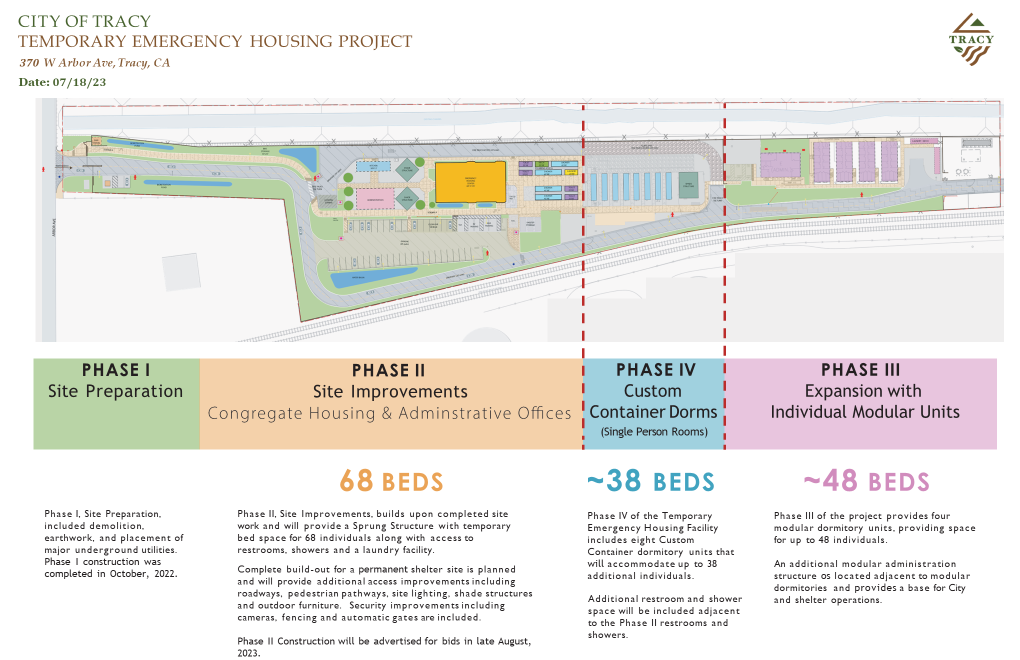

Site Preparation included changes to the existing site to prepare the site to house the temporary emergency housing facility project. Work included demolition of existing onsite structures, significant earthwork and placement of major underground utilities.
November 1, 2022
The Expansion with Individual Modular Units phase was completed prior to Site Improvements as the need for an operable shelter was required to be met prior to completion of the main construction project. A total of five modular structures were relocated to the site, four of which are dormitories and one of which is an administration structure currently housing shelter operations.
December 2023
The Custom Container Dormitories phase built upon the Modular Units to provide additional bed space prior to completion of the main construction project. This phase includes eight custom container dormitory units each housing a maximum of five individual sleeping rooms. In addition, additional restroom and shower spaces are being constructed as part of Site Improvements which will replace current temporary restrooms and showers and will act as permanent restroom and shower facilities to serve these dormitories.
November 2024
- Start of Construction
- Earthwork
- Site Fencing
Site Improvements contain much of the project construction and is the last phase to be completed, with an estimated completion date of December 2025.
